                                The Monteith Park and View Park Green Alley Stormwater
                Improvements Project is located in the unincorporated area of
                View Park, the Project will capture and infiltrate urban runoff
                and stormwater from 228 acres of primarily residential and
                commercial land from neighboring areas.


                                The use of this water will help offset potential drought
                conditions as well as improve downstream waterbodies such as
                Ballona Creek and the Santa Monica Bay.




                            Partners


















                                • Los Angeles County Supervisor Holly Mitchell
                                • County of
                Los Angeles Department of Parks and Recreation
                                • Los
                Angeles County Flood Control District
                                • California State
                Coastal Conservancy
                                • California State Department of Water
                Resources
                                • Safe Clean Water Program


                            Funding for this project has been provided in part by the Safe
              Neighborhood Parks, Clean Water, Clean Air and Coastal Protection
              Bond Act of 2000 (Proposition 12) and the Coastal Conservancy. The
              Coastal Conservancy is a California state agency, established in
              1976, to protect and improve natural lands and waterways, to help
              people get to and enjoy the outdoors, and to sustain local
              economies along California’s coast. It acts with others to protect
              and restore, and increase public access to, California’s coast,
              ocean, coastal watersheds, and the San Francisco Bay Area. Its
              vision is of a beautiful, restored, and accessible coast for
              current and future generations of Californians.


                            Funding for this project has been provided in full or in part from
              the Water Quality, Supply, and Infrastructure Improvement Act of
              2014 and through an agreement with the State Department of Water
              Resources.


                            Funding for this project has also been provided in part from the
              Los Angeles County Flood Control District’s Safe, Clean Water
              Program.




                                | SCHEDULE |

                                | Final Design | October 2022 |

                                | Advertisement and Award | January 2023 |

                                | Construction Start | September 2023 |

                                | Project Completion | August 2025 |

                                | Effectiveness Monitoring | Late 2028 |


                        Updates

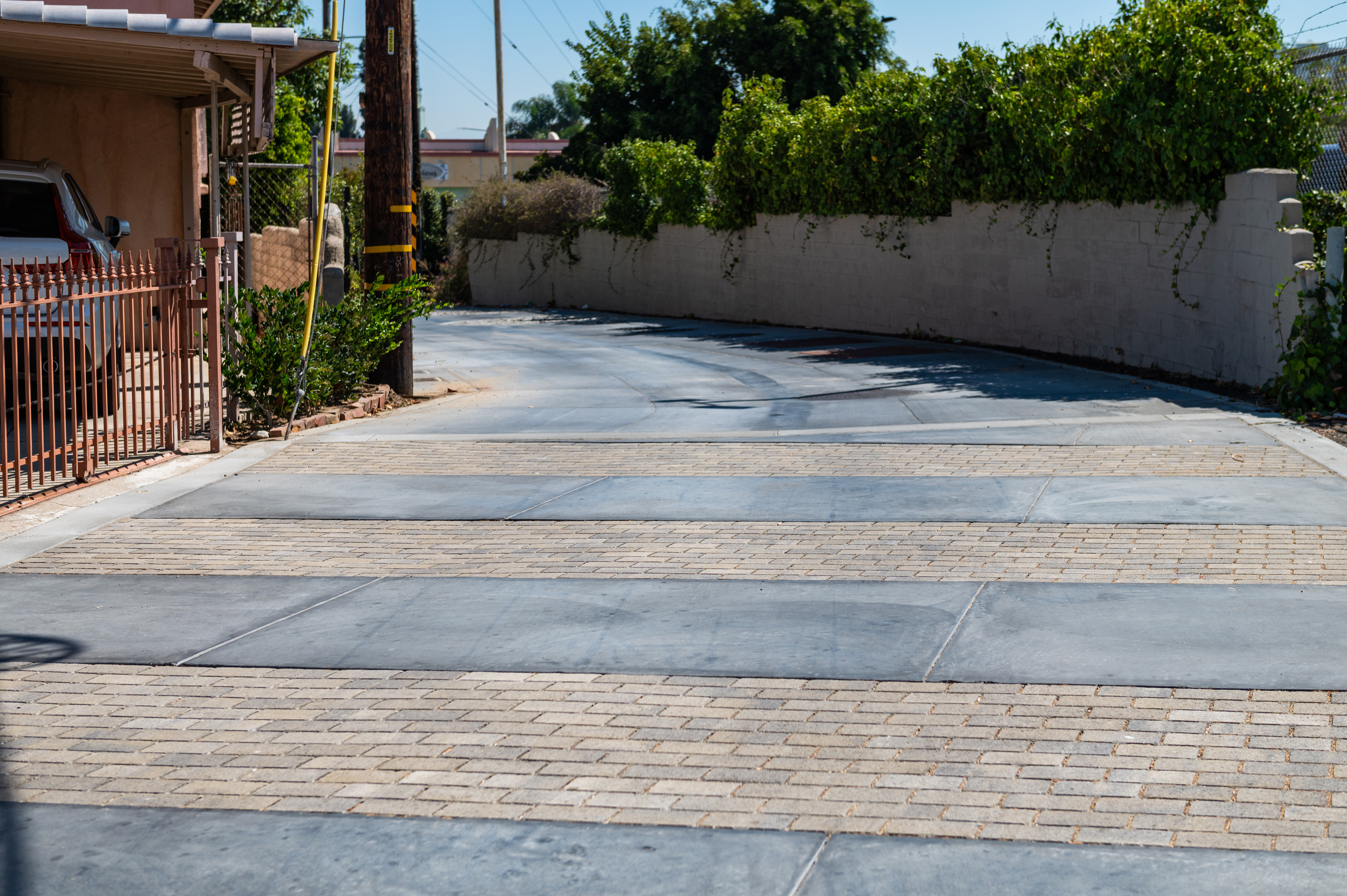

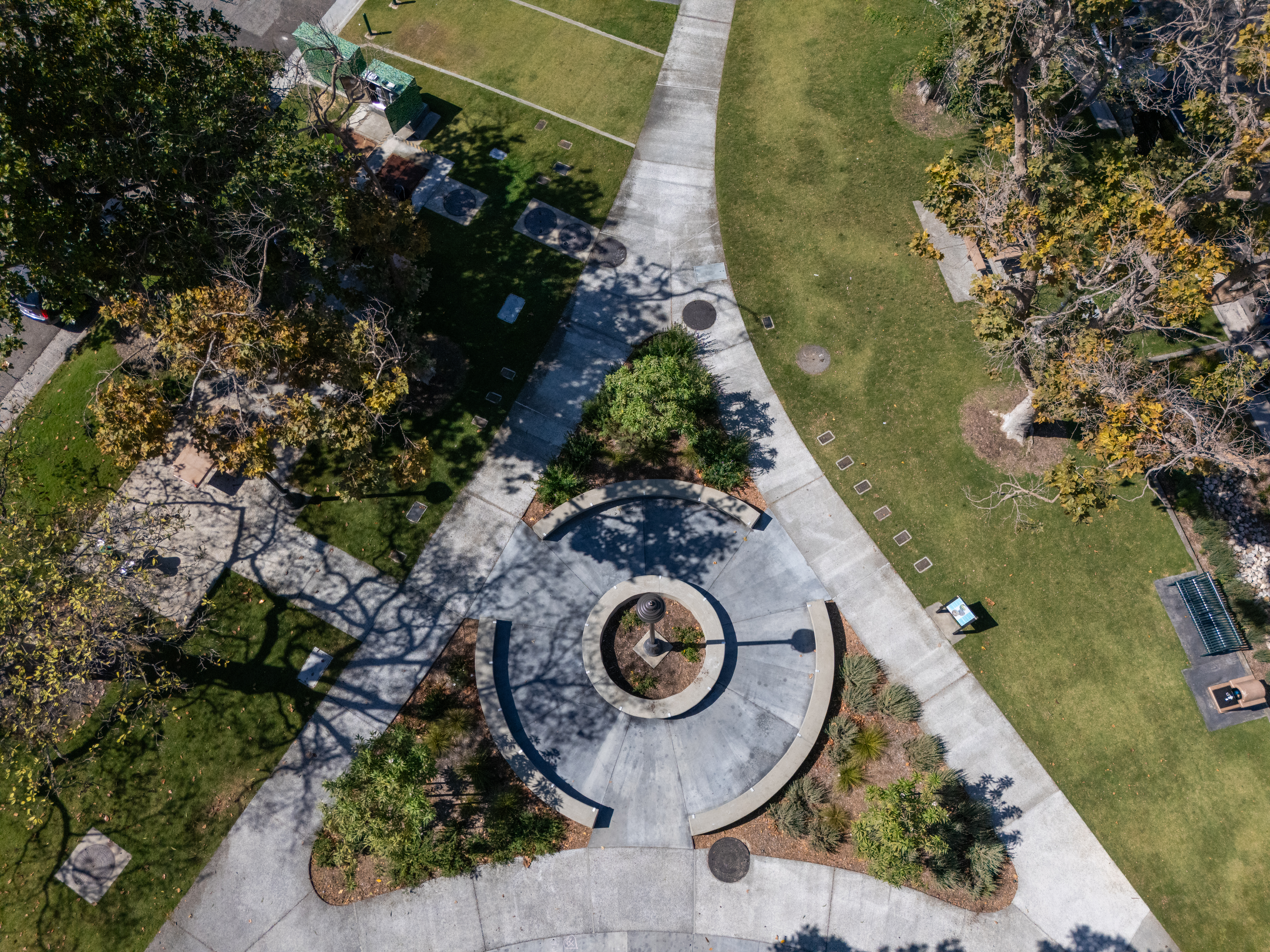

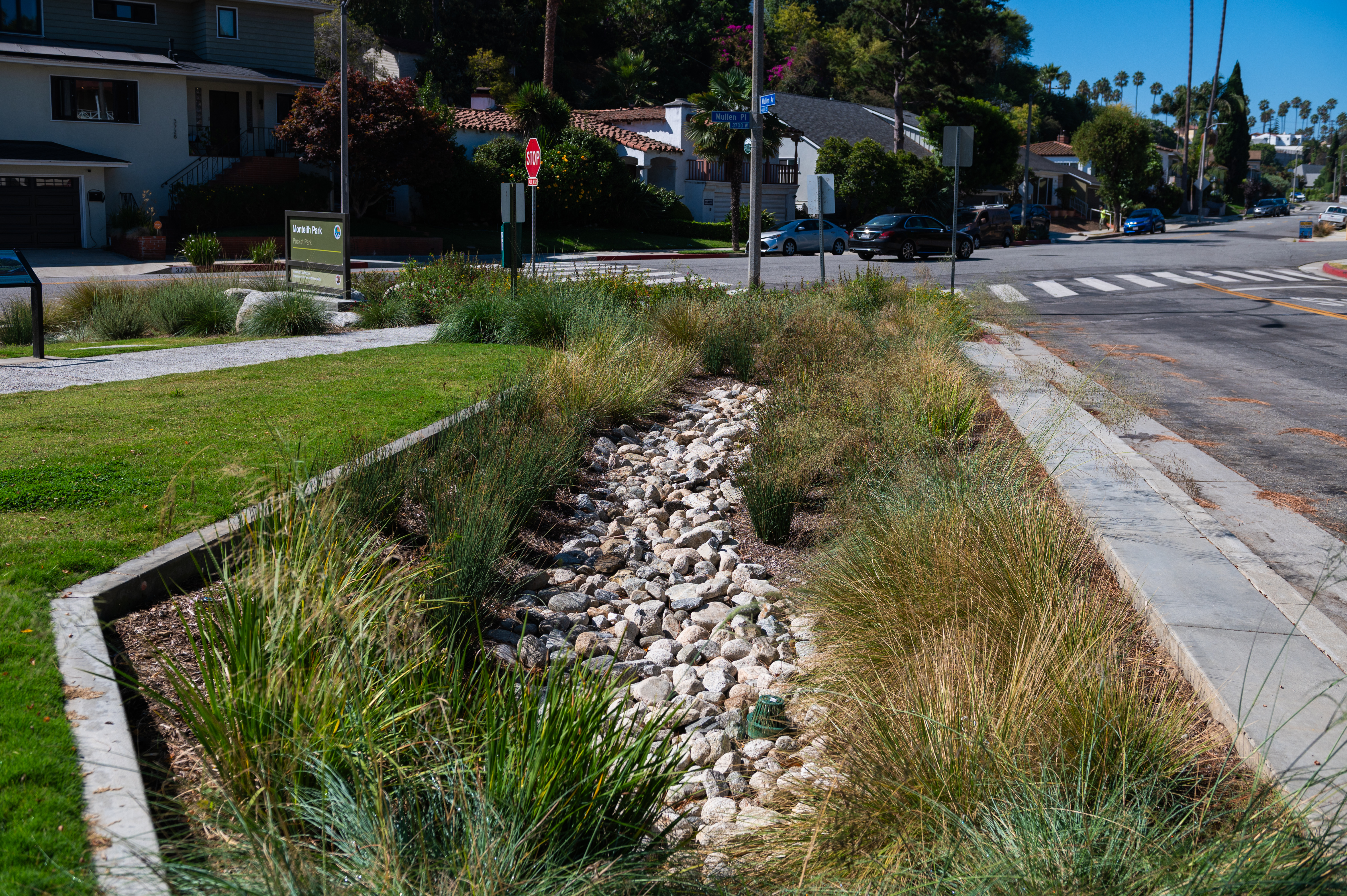

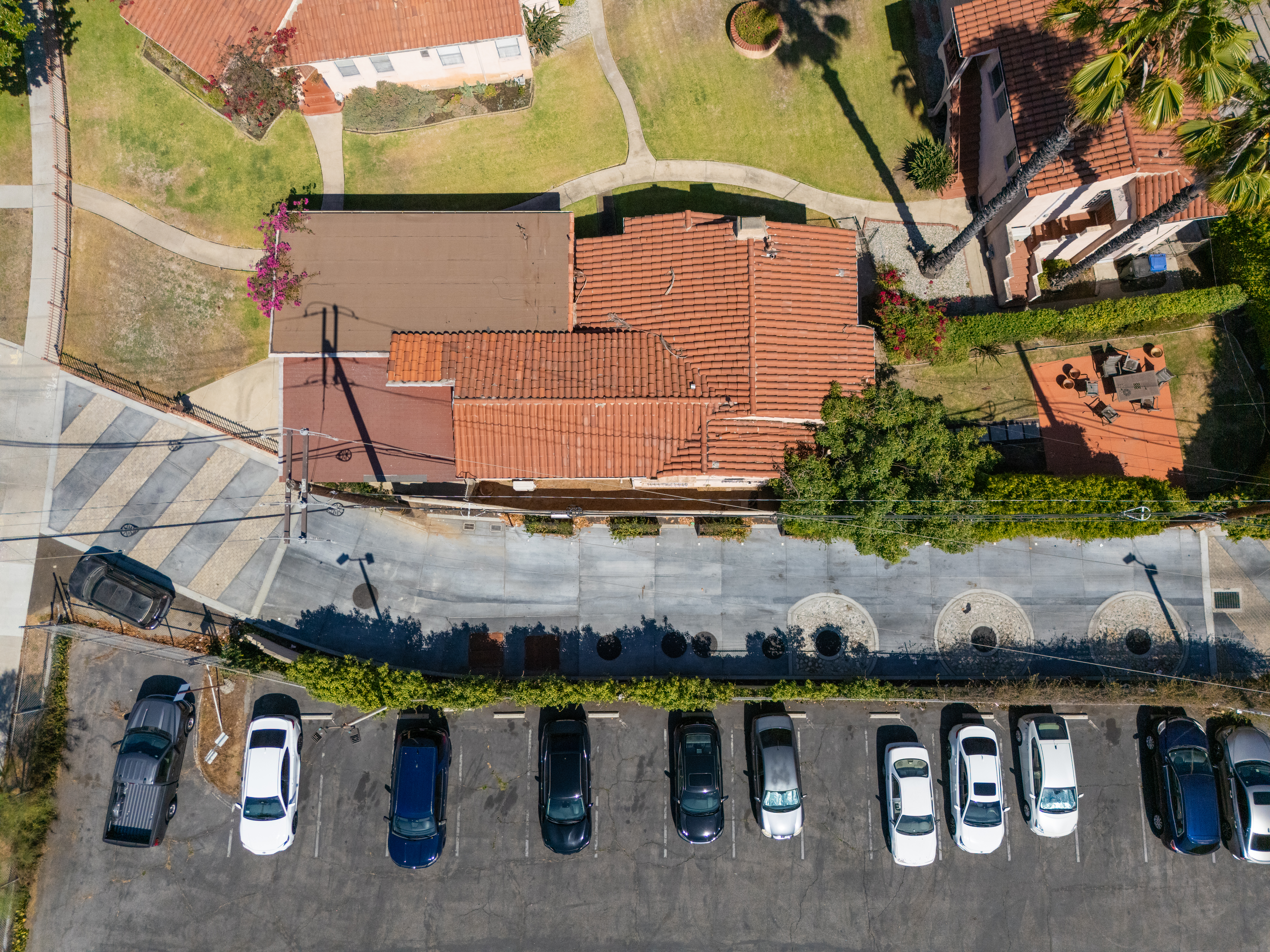

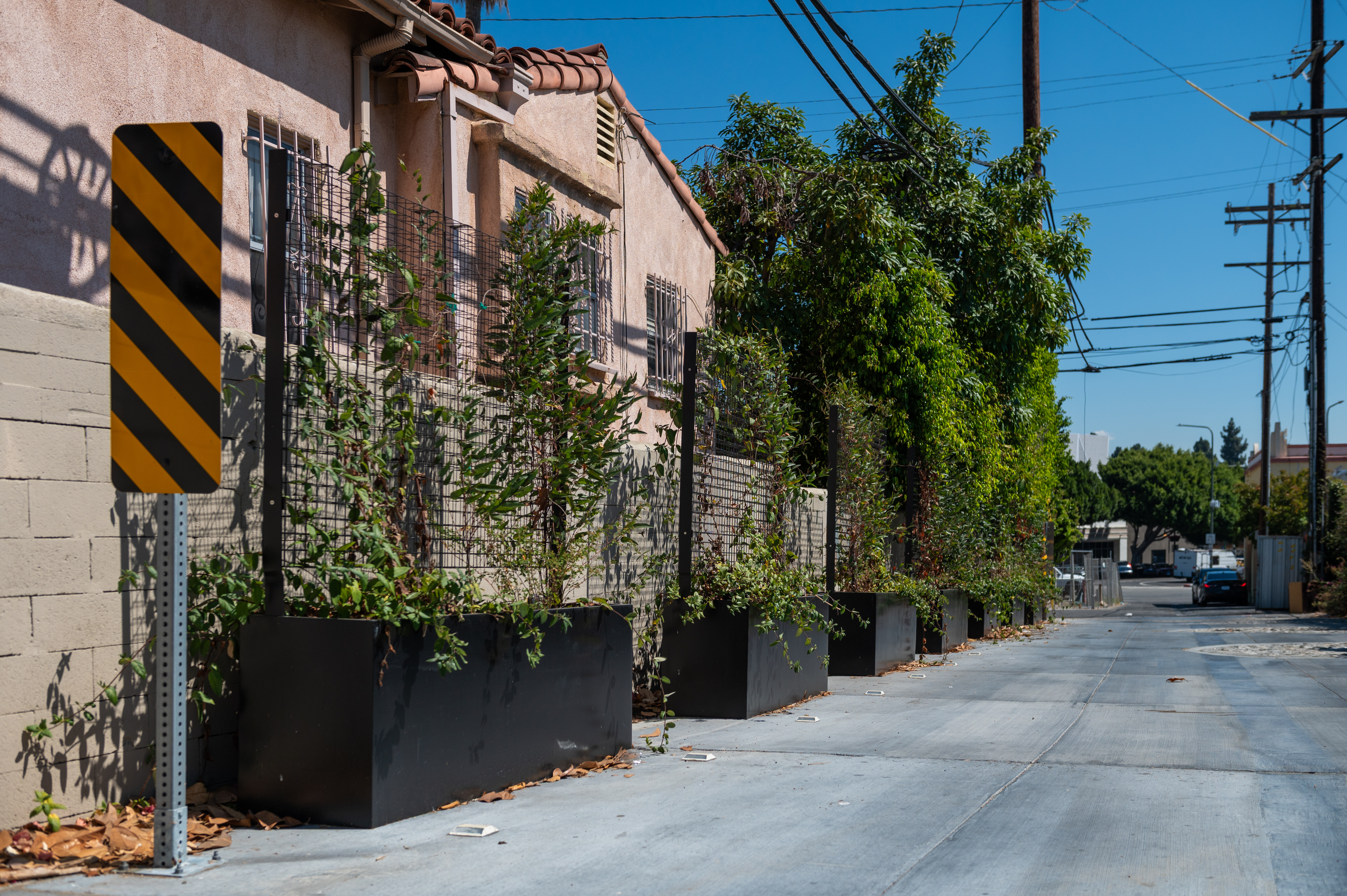

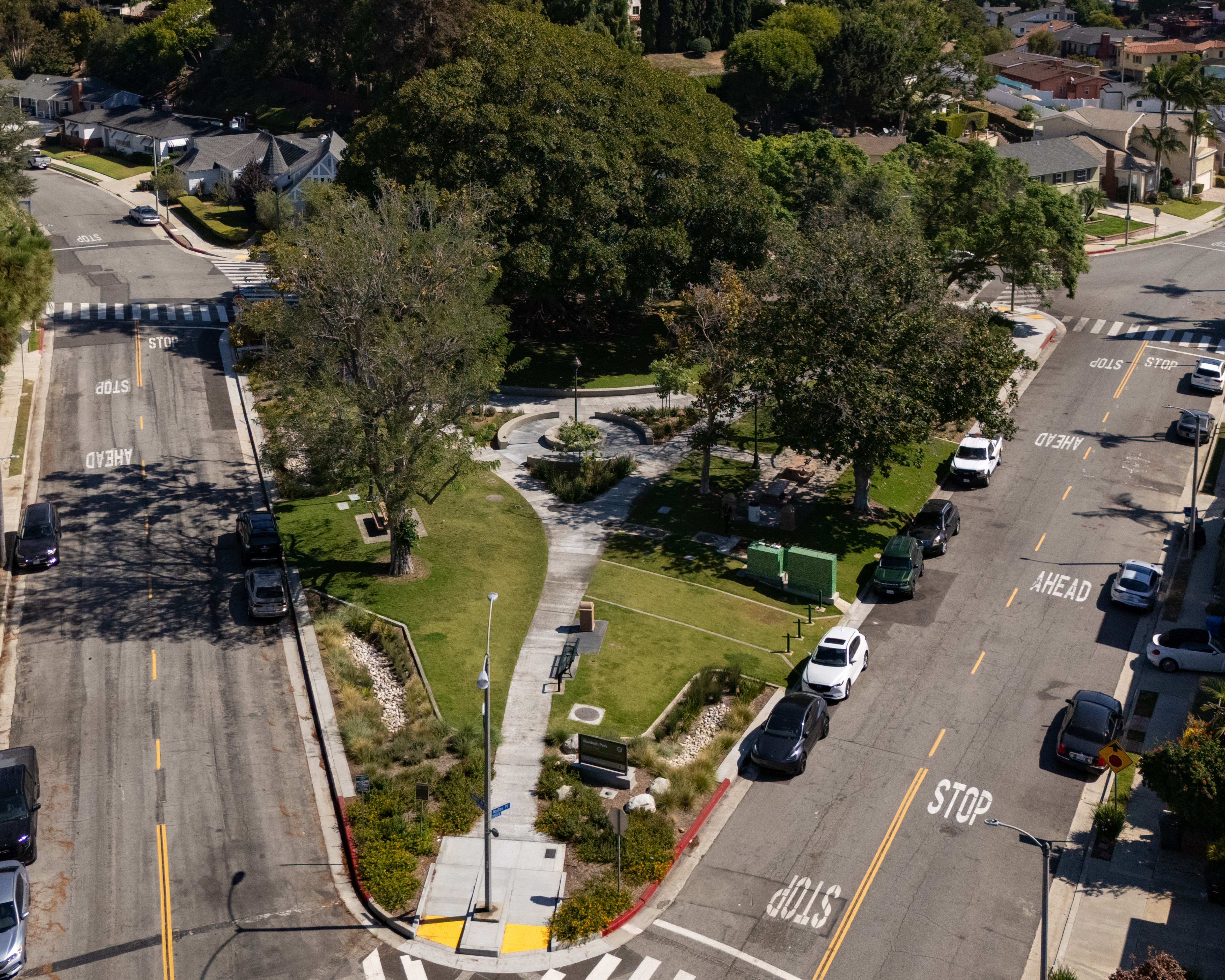

                        Project reached substantial completion on August 21, 2025. Please see photos showcasing the finished project below.







                        March 13, 2025


                        The alley has been reopened to the public.


                        December 2, 2024



                        The park has been reopened to the public.


                        October 23, 2024


Landscaping work including planting new grass in the park will be completed by October 30, 2024 and we anticipate reopening the park to the neighborhood on December 2, 2024. The View Park Alley is anticipated to be completed and reopened in November 2024.

                        September 10, 2024


                        Due to unforeseen delays with the landscaping work, construction activities at Monteith Park will be concluding mid-October 2024 and we anticipate reopening the park to the neighborhood mid-November 2024 to allow the new turf to establish their roots. The View Park Alley is anticipated to be completed and reopened mid-October 2024.


                        July 20, 2024


                        A community information session was held on Saturday July 20, 2024. Thank you to the community members who joined to learn about the project and share feedback. Please see below for the presentation slides.




                        July 16, 2024


                        We are excited to report that construction of the Project is progressing well. Construction activities at Monteith Park will be concluding in August 2024 and we anticipate reopening the park to the neighborhood in mid-September 2024 to allow the new turf to establish their roots.
                        The View Park Alley is anticipated to be completed and reopened by mid-August 2024.


                        November 3, 2023


                        Please click on the following link to view the alley closure flyer that will be mailed out to neighbors surrounding the park site by November 2, 2023:


Alley Closure Flyer


                        August 29, 2023


                        Please click on the following link to view the preconstruction flyer that will be mailed out to neighbors surrounding the park site by September 1, 2023:



Preconstruction Flyer


                        August 3, 2023


                        Monteith Park will begin its closure to the public in late August 2023 for approximately 1 year of construction. Parking along the park’s curbside will be restricted at some locations. Please follow all construction signage including no-parking signs. Notices to move parked vehicles will be posted at least 24-hours in advance. Public Works will be distributing informational flyers to the neighbors surrounding the park with additional construction details. The flyer will be posted on this website when available.


                        April 14, 2023


                        A community information session was held on Friday April 14, 2023. Thank you to the community members who joined to learn about the project and share feedback. Please see below for the presentation slides.



                        February 16, 2023


                        The construction contract was awarded to Clarke Contracting Corporation on January 26, 2023. Construction is expected to start in August 2023 and be completed in Summer 2024. Click on the links below for the project plans and specifications.



                        October 4, 2022


                        The Project is currently being advertised. Please visit the
Public Works Business Opportunities for more details.


                        May 20, 2021


                        Project is currently in design.


                        October 5, 2020

                        A virtual community information session was held on Wednesday
            September 23, 2020. Thank you to the community members who joined to
            learn about the project and share feedback. Please see below for the
            presentation slides and notes, including questions and answers from
            the evening.






                        Community Meetings

                        Below is a summary of the community meetings conducted for the Project to date:




                                | No. | Date | Time | Location |

                                | 1 | June 26, 2019 | 7:00 PM | Monteith Park (In-person) |

                                | 2 | September 26, 2019 | 6:00 PM | Yvonne B Burke Senior & Community Center (In-person) |

                                | 3 | September 23, 2020 | 6:00 PM | Web-Ex (Virtual) |

                                | 4 | April 14, 2023 | 11:00 AM | Monteith Park (In-person) |

                                | 5 | July 20, 2024 | 10:00 AM | Park Hills Community Church Sanctuary - (In-person) |




                        Additional Information





                            Contact


                            • To receive project updates, please contact Josafat Flores at
              joflores@pw.lacounty.gov
